US 8, WIS 55 to Otter Creek Road

 Forest County

Schedule and Traffic Impacts

Page last updated: Oct. 3, 2025

Schedule: April 14 to Oct. 31, 2025

Anticipated work scheduled: Crews will:

  • Continue installing erosion control and landscaping throughout the projects.
  • Grade the subgrade and place base material along trails.
  • Continue milling and paving in an easterly direction toward Laona.

Traffic impacts (the next 10 days):

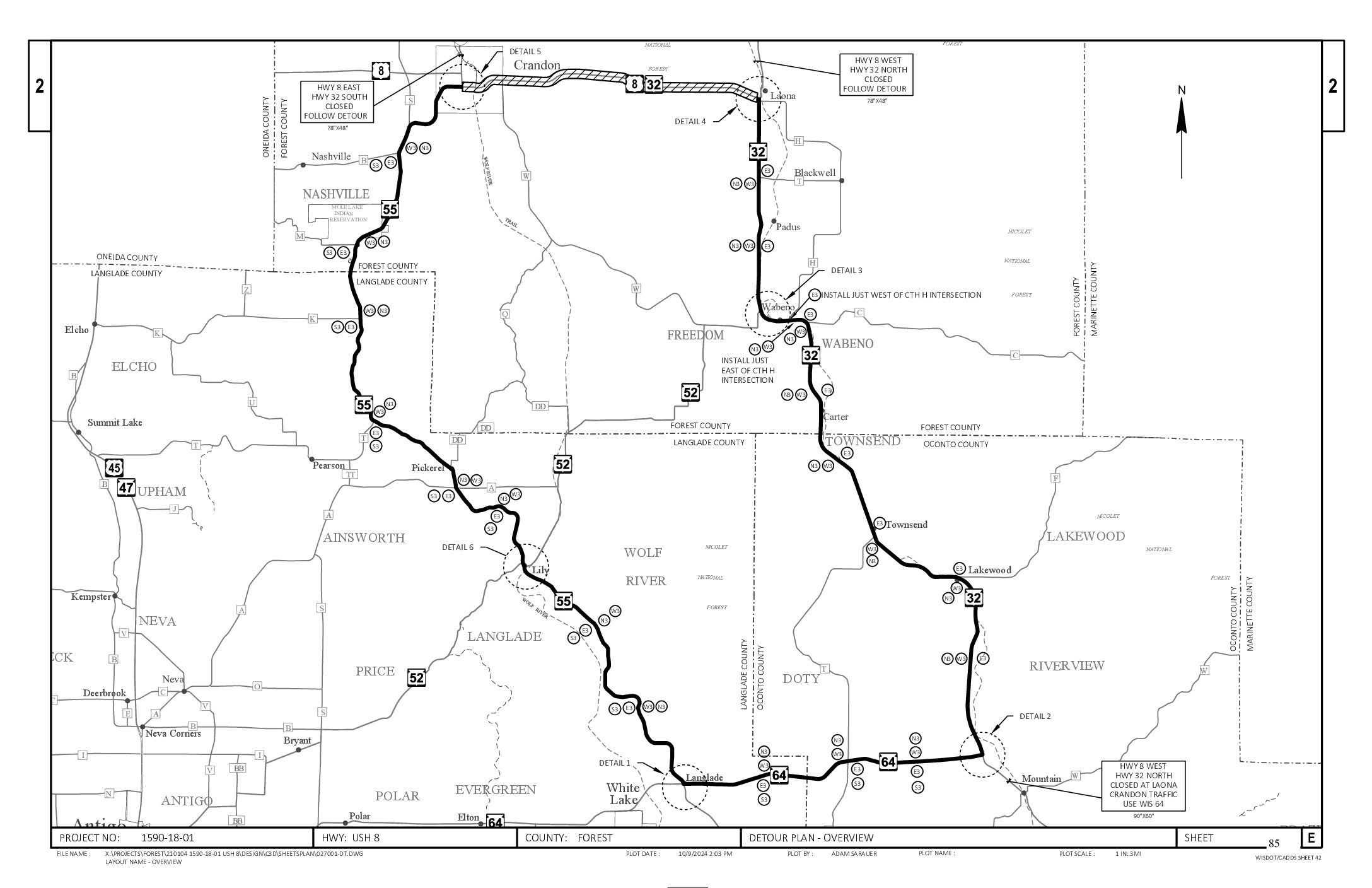

  • US 8 is closed to thru traffic from the intersection of WIS 55/WIS 32/US 8 in Crandon to the intersection of WIS 32/US 8 in Laona until Saturday, Oct. 18
  • No public traffic access from Firekeeper Road to just east of Indian Drive including the intersection of Kwe Da Kik Lane and Youngs Lane
  • Traffic will encounter shoulder closures and flaggers at various times throughout the project limits listed above through Nov. 1.
